Residue from the flush is what changes the coolant.
Flushing is the last operation before a loop is charged, and whatever the flush water leaves behind goes into the coolant and moves its conductivity. We supply what the step consumes: the cart, its two elements, the sampling points and the instruments that read them.
One cart, two hoses, one manifold. Everything on this sheet is what the cart holds and what it is judged by.
The four operations, in the order they are run
Step 01. Drained from the lowest point, filled from the highest. Debris sits where the water stops moving.
Step 02. The gauge between the two housings is the whole instrument panel for this step.
Step 03. Drawn from the return, not from the tank: the sample has to be the fluid that has been through the loop.
Step 04. Charged from a sealed drum through a short hose. The longer the charge path, the more of it is not the coolant.
Held for this step · the four-step sequence · the differential at which an element is spent · the sampling point on the drawing · the charge connection size
The cart is quoted on three figures, and we set one of them
| No | Figure | Set by | What it has to be |
|---|---|---|---|
| 01 | Tank volume the largest of the three | the loop | The loop volume plus whatever the drain-down releases. A tank smaller than the drain has to be emptied mid-flush, and the second fill is not the same water as the first |
| 02 | Pump flow read on the cart's own meter | the loop | Matched to the loop's design flow. Running faster does not clean harder: past the element's rating the flow goes round it rather than through it |
| 03 | Filtration stages two | ours | A 10 µm first stage and a 1 µm second stage. One stage would take both loads at once and pass the finer particles while it did |
| 04 | Element length housing envelope | the cart | 20 in and 40 in in the standard housings, 10 in on a small branch. The length buys surface area, not a finer rating |
| 05 | Element change differential | the element | 0.5 – 0.7 bar across the housing. Past it the element is bypassing, and the loop is being circulated, not filtered |
| 06 | Sampling point on the return | the drawing | Upstream of the charge connection, so the sample is taken from fluid that has already been round |

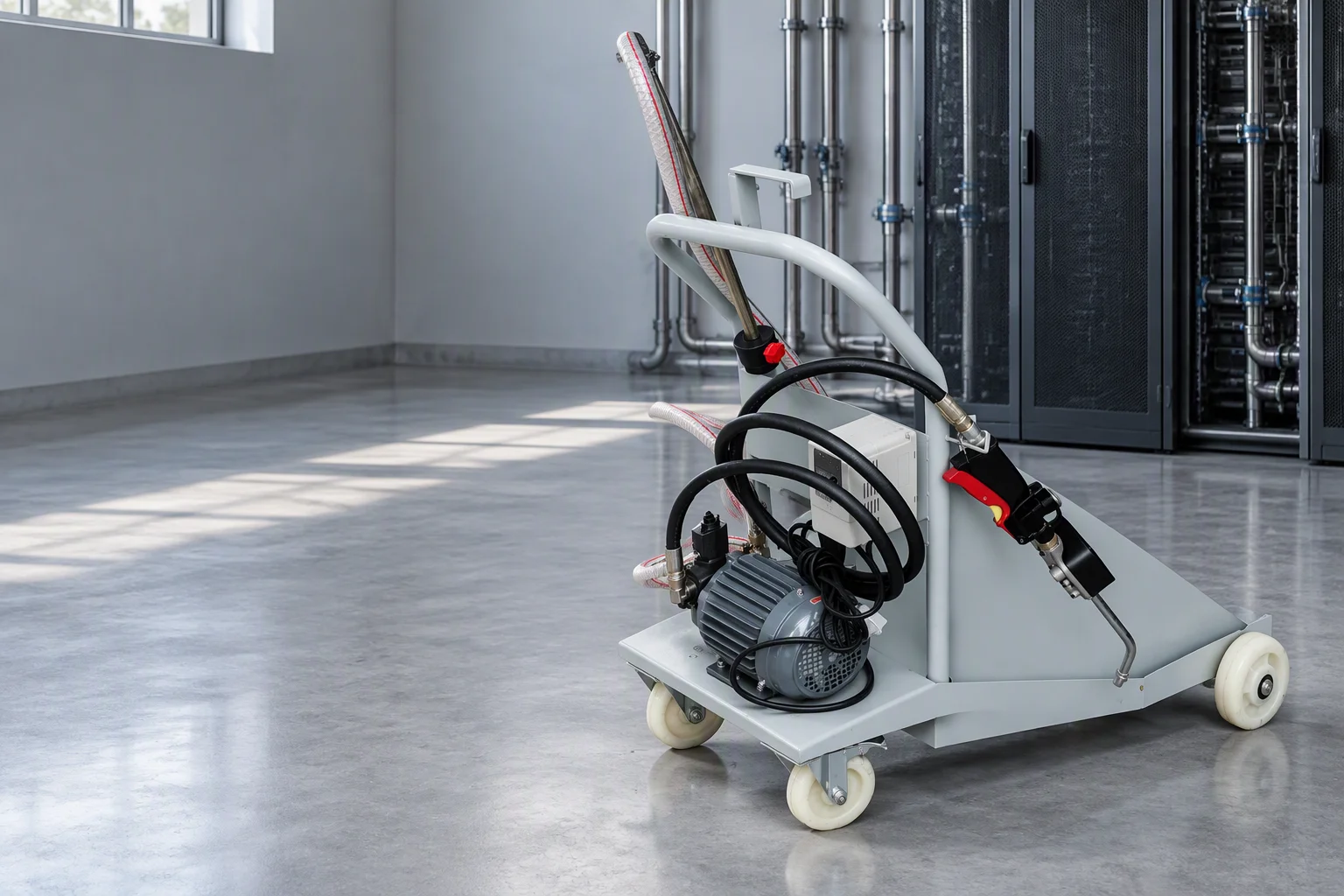

The cart as delivered: two housings, two valves, one gauge, one pump, and a frame that rolls.
Supply and return land side by side. Getting them the wrong way round is the one mistake the cart cannot correct for you.
The tail the cart's hose lands on. A and B are the two figures the fitter measures before the collar goes on.
The coupling face. The seal land is the only part of it that has to be clean before the collar is closed.
Also specified on the same sheet · housing material · element rating per stage · connection size · frame and castors · gauge range · pump seal elastomer
The number the flush is judged against
One target, three code numbers. A loop is not clean because a sample looks clear; it is clean when the sample reports the code the sheet asks for, and the owner may ask for a stricter one than ours.
The flush water is not the coolant and is not left in the loop. What stays behind after the drain goes into the charge and shows up as a shift in conductivity, which is why the target is written as a cleanliness figure and not as a number of flushes.
All three have to be met at the same sampling. The finest of the three is the one that usually decides how long the flush runs.
First stage loaded, second stage clean. That difference is what a second stage is bought for.
The ladder runs 0.05 µm to 100 µm in eight steps. The flush uses two of them, not eight.
The joint the cleanliness is kept for. A particle trapped on this profile is a weep that starts in service, not on the bench.
What the target is written against · ISO 4406 17/15/12 before charge · a stricter owner figure where one is specified · the same three classes on every sample · the element rating that gets the loop there
Where the sample is drawn decides what it says
- Draw from the return leg, never from the tank or the drum.
- Flush the valve first and take the sample second: the first fluid out of a dead leg is the dead leg.
- Take it with the pump running, so the sample is what is in circulation.
- Read it against the same three classes each time, so two samples can be compared.
- Hold the sample until the charge is finished: if the loop is reworked, the sample is the baseline.
The tap. Short tail, tray underneath, boss welded on the return where the fluid is still moving.
Read on the spot. A sample that travels to a laboratory is a sample that has had time to settle.
A sample per cycle, in order. The trend across the rack is the evidence that the flush is converging.
What ships with a cart
On this line · Fill and flush carts · Commissioning consumables · Filter cartridges · Fluid quality monitoring
Request the flush and fill schedule
The flush schedule, the two element ratings, the material certificate and the outline drawing. Tick what you need.
One business day, with the file attached.
Nothing else on this sheet is promised. Price, stock and lead time are quoted against a request.
The element that does the work. Its rating is the first number on the schedule and the first thing quoted back.
Two readings on the panel: how loaded the element is, and what the pump is actually moving.
